Warren Towers Renovation Construction Update – 9/25/2026
General Project Information
- The team is currently in the main renovation phase of the project.
- Weekday shifts run from 7:00 a.m. to 3:30 p.m. (1st shift) and 3:00 p.m. to 11:00 p.m. (2nd shift). Weekend shifts run from 7:00 a.m. to 3:30 p.m. (1st shift).
- Work on the exterior, outside and adjacent to student rooms, will be performed from 9:00 a.m. to 5:00 p.m.
- Work on the street level, inside the fenced construction area, and deliveries will begin at 7:00 a.m.
- Anyone entering the jobsite must be authorized personnel, as no trespassing is permitted. Anyone wishing to enter the site must sign in at the construction field office and observe and comply with all posted signage and personal protective equipment requirements.
- Emergency Contacts:
- The Owner’s Representative is Corey Davidson of Leftfield Project Management, who can be reached at 508-330-8489.
- The Contractor Representative is Matt Galloway of Shawmut Design & Construction, who can be reached at 617-413-7758.

During the Weekend of 9/25/26
Saturday (1st Shift), Sunday (No Planned Work)

Exterior Work
Tower A
- No exterior work is planned for this weekend.
Tower B
- No exterior work is planned for this weekend.
Podium A Roof
- No exterior work is planned for this weekend.
Podium B Roof
- No exterior work is planned for this weekend.
Podium C Roof
- No exterior work is planned for this weekend.
Podium D/Multipurpose Roof
- No exterior work is planned for this weekend.
Rear Alley & South Elevation
- No exterior work is planned for this weekend.
West Podium Terrace & West Elevations
- No exterior work is planned for this weekend.
Commonwealth Ave. & North Elevation
- No exterior work is planned for this weekend.
Hinsdale Mall & East Elevation
- No exterior work is planned for this weekend.
- Please watch for sidewalk closures, BUPD detail officers, cones, and observe signage.
Cummington Mall West & West Elevation
- No exterior work is planned for this weekend.
- Please watch for intermittent closures, BUPD detail officers, cones, and observe signage.
Cummington Mall
In and around the fenced area

- Daily deliveries of construction materials and the load-out of demolition debris dumpsters are ongoing.
- The two-car personnel and materials hoist way is in operation for Tower B.
- The elevator operators begin their daily safety checks and preventative maintenance on the hoist way at 6:00 a.m.
Interior Work
Main Entrance Lobby
- Fire alarm monitoring and programing work is ongoing in fire command center.
4th Floor
- Construction staff will be onsite all weekend monitoring the inside of the building, looking to respond to any storm related water intrusion.
Tower A
- Crews may need to access and work on the low roofs (east and west of Tower A) adjacent to student rooms.
- Please keep blinds, drapes, and window treatments closed for privacy.
Tower B
- Demolition is ongoing, and debris is loaded into hampers, transported, and emptied into dumpsters located in the construction loading dock.
- Survey crews are setting benchmarks and layout points on each floor.
- Floor slab leveling, coring, cutting, and grinding is ingoing.
- Cutting of the concrete slab edge at every widow opening is ongoing.

- Installation of fire protection sprinkler risers, mains, branch lines and heads is ongoing.
- Rough HVAC sheet metal ductwork, piping, and controls wiring is ongoing.
- Fuel oil riser installation is ongoing.
- Rough plumbing is ongoing.
- Rough electrical and fire alarm work is ongoing.

- Installation of structural steel clips, plates, kickers and beam penetrations is ongoing.
- Interior steel stud framing of walls, soffits, and ceilings is ongoing.
- Installation of hollow metal door frames is ongoing.
- Application of spray fireproofing, expanding foam insulation, and firestopping continues.

Tower C
- Crews may need to access and work on the low roofs (east and west of Tower C) adjacent to student rooms.
- Please keep blinds, drapes, and window treatments closed for privacy.
Multipurpose Room
- No work is planned over the weekend.
Dining Hall
- No work is planned over the weekend.
Parking Garage

- Plumbers are installing new equipment, water and drain lines in the basement, 1st, 2nd, 3rd levels.
- Concrete and steel structural repair work continues in the parking garage on 1st, & 2nd, 3rd floors.
- Sprinkler work on all levels and will be ongoing.
- Excavation and installation of new drainage piping, gas and oil separator equipment in the basement is ongoing.
During the Week of 9/21/2026
Crews Will Be Working 1st & 2nd Shifts
Exterior Work
Tower A
North, South, East and West Facades
- No work is planned.
Upper Roof
- Mechanical equipment commissioning is ongoing.
Tower B
North, South, East and West Facades
- Masons will continue exterior brick veneer restoration work, selective demolition, and the installation of restoration anchors, air, water, and vapor barriers, new lintels, flashings, and relieving angles.
- Steel stud framing and sheathing at exterior window walls and openings is ongoing.
- Installation of air and water barriers is ongoing.
- Installation of windows is ongoing.
Upper Roof
- New parapet construction is ongoing.
- Masonry restoration on the elevator machine room headhouse is ongoing.
- Work on the structural stub columns is ongoing.
- Concrete cutting and coring at the fresh air duct risers is ongoing.
- Concrete curbs for mechanical penthouse are ongoing.
- Installation of new roofing system is ongoing

Podium A Roof
- Commissioning of the new dining hall mechanical equipment is ongoing.
Podium B Roof
- Commissioning of the new dining hall mechanical equipment is ongoing.
Podium C Roof
- The area is being used as a staging laydown area.
Podium D/Multipurpose Roof
- The area is being used as a staging laydown area.
- Work continues constructing the new Boiler Room.
- South parapet demolition and reconstruction is ongoing.
Rear Alley & South Elevation
- Concrete and steel structural repair work continues in isolated work zones.
West Podium Terrace & West Elevations
- Assembly and installation of heat pumps and condensers, piping, and electrical connections is ongoing.
- HVAC equipment start-up and commissioning is ongoing.
- Work on the acoustic roof screen assembly is ongoing.
Commonwealth Ave. & North Elevation
- Masons will continue exterior brick veneer restoration work, selective demolition, and the installation of restoration anchors, air, water, and vapor barriers, new lintels, flashings, and relieving angles.
Hinsdale Mall & East Elevation
- Masons will continue with exterior brick veneer restoration work, selective demolition, installation of restoration anchors, air water and vapor barriers, new lintels, flashings, and relieving angles.
- Please watch for sidewalk closures, BUPD detail officers, cones, and observe signage.
Cummington Mall West & West Elevation
- Metal panel installation/punch list is ongoing.
- Please watch for intermittent closures, BUPD detail officers, cones, and observe signage.
Cummington Mall
In and around the fenced area.
- Beginning Monday, a large crane will be set up within the fence line, West of the construction loading dock to hoist the roof platform and penthouse steel onto the upper roof of Tower B.
- Daily deliveries of construction materials and the load-out of demolition debris dumpsters are ongoing.
- The two-car personnel and materials hoist way is in operation for Tower B.
- The elevator operators begin their daily safety checks and preventative maintenance on the hoist way at 6:00 a.m.
Interior Work
Main Entrance Lobby
- Fire alarm monitoring and programming work in the fire command center.
Tower A
- The construction team may be intermittently in the tower to address and repair issues if they arise. These tasks are scheduled, and workers will be escorted to the work areas and supervised.
- Crews may need to access and work on the low roofs (east and west of Tower A) adjacent to student rooms.
- Please keep blinds, drapes, and window treatments closed for privacy.
Tower B
- Demolition is ongoing, debris is loaded into hampers, transported and emptied into dumpsters located in the construction loading dock.
- Survey crews are setting benchmarks and layout points on each floor.
- Floor slab leveling, coring, cutting, and grinding is ongoing.

- Work on the concrete slab infills is ongoing.
- Cutting of the concrete slab edge at every widow opening is ongoing.
- Installation of fire protection sprinkler risers, mains, branch lines and heads is ongoing.
- Rough HVAC sheet metal ductwork, piping, and controls wiring is ongoing.
- Fuel oil riser installation is ongoing.
- Rough plumbing is ongoing.
- Rough electrical and fire alarm work is ongoing.

- Installation of structural steel clips, plates, kickers, and beam penetrations is ongoing.

- Interior steel stud framing of walls, soffits, and ceilings is ongoing.
- Installation of hollow metal door frames is ongoing.
- Application of spray fireproofing, expanding foam insulation, and firestopping continues.

Tower C
- Crews may need to access and work on the low roofs (east and west of Tower C) adjacent to student rooms.
- Please keep blinds, drapes, and window treatments closed for privacy.
Multipurpose Room
- No work is planned.


Dining Hall
- Mechanical systems commissioning is ongoing.
Parking Garage
- Plumbers are installing new equipment, water and drain lines in the basement, 1st, 2nd, and 3rd levels.
- Concrete and steel structural repair work continues in the parking garage on 1st, & 2nd, and 3rd floors.
- Jackhammer demolition will be ongoing and produce intermittent noise.

- Sprinkler work on all levels and will be ongoing.

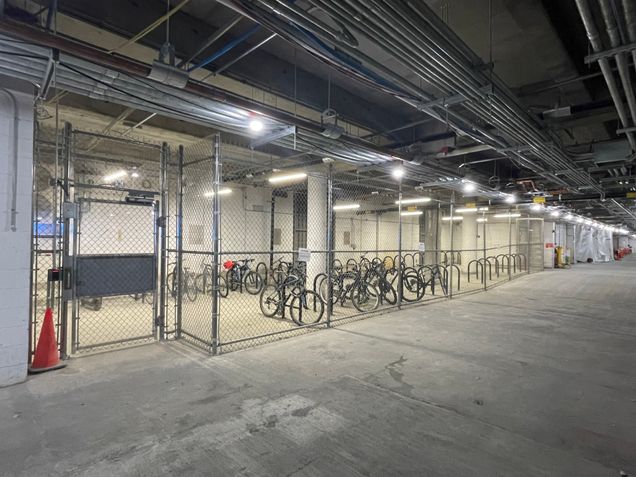

- Masons are installing block walls in the new bike storage room.
- Excavation and installation of new drainage piping, gas and oil separator equipment in the basement is ongoing.
Future/Notable Tasks
- Tower B substation equipment will arrive in late October.
- The second delivery of windows for Tower B will arrive.
- Planning for winter intersession work is ongoing.
