General Project Information
- Warren Towers Dining Hall, Offices, Student Rooms, Parking Garage (Lot K), and Bike Storage Room are now closed for the summer.
- Weekday shifts run from 7:00 a.m. to 3:30 p.m. (1st shift) and 3:00 p.m. to 11:00 p.m. (2nd shift). Weekend shifts run from 7:00 a.m. to 3:30 p.m. (1st shift) and 3:00 p.m. to 11:00 p.m. (2nd shift).
- Work on the exterior, outside/adjacent to student rooms, will be performed from 9:00 a.m. to 5:00 p.m.
- Work at street level, inside the fenced construction area, and deliveries will begin at 7:00 a.m.
- Entering the jobsite: Authorized personnel only and no trespassing. Anyone wishing to enter the site must sign in at the construction field office, observe and comply with all posted signage and personal protective equipment requirements.
- Emergency Contacts:
- Owner’s Representative – Leftfield Project Management: Corey Davidson – 508-330-8489
- Contractor Representative – Shawmut Design & Construction: Matt Galloway – 617-413-7758
Access to 111 Cummington Mall

During the Weekend of 8/15/26
Saturday & Sunday (1st shift)
Exterior Work

South Alley
- Concrete and steel structural repair work continues.
- The closed area will be adjusted this weekend; crews will reduce the closed area by relocating the barrier easterly.
Tower A
North, South, East and West Facades
- Flashing tie-in work at exterior wall and podium roof intersections.
Upper Roof
- Mechanical equipment commissioning.
Tower B
North, South, East and West Facades
- Masons will continue with exterior brick veneer restoration work, selective demolition, installation of restoration anchors, air, water, and vapor barriers, new lintels, flashings, and relieving angles.
- Steel stud framing and sheathing exterior window walls and openings.
Upper Roof
- New parapet construction is ongoing.
- Masonry restoration on elevator machine room headhouse.
- Work on structural stub columns.
- Concrete cutting and coring at fresh air duct risers.
Podium A Roof
- Installation of new roofing and flashing systems.
- Start-up, testing, and commissioning of new mechanical equipment.
Podium B Roof
- Installation of new roofing and flashing systems.
- Skylight trim detail work.

- Start-up, testing, and commissioning of new mechanical equipment.
Podium C Roof
- Staging laydown area.
Podium D/Multipurpose Roof
- Staging laydown area.
- Work continues constructing the new boiler room.
West Podium Terrace

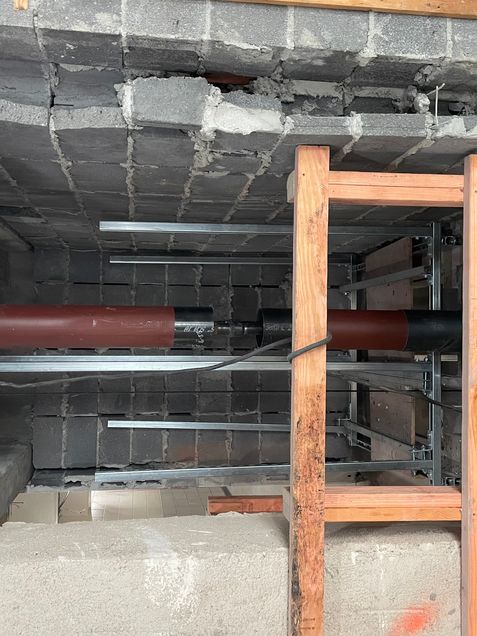

- Assembly and installation of heat pumps and condensers, piping, and electrical connections.
- HVAC equipment start-up and commissioning.
- Work on the acoustic roof screen assembly is ongoing.
Commonwealth Ave.
- Masons will continue with exterior brick veneer restoration work, selective demolition, installation of restoration anchors, air, water, and vapor barriers, new lintels, flashings, and relieving angles.
Cummington Mall
In and around the fenced area.
- Daily deliveries of construction materials and load-out of demolition debris dumpsters.
- Two-car personnel and materials hoist way in operation for Tower B.
- The elevator operators begin their safety checks and preventative maintenance on the hoist way daily at 6:00 a.m.
Cummington Mall West
- Crews are cleaning, organizing, and preparing to open the road for the academic year.
- Please watch for intermittent closures, BUPD detail officers, cones, and observe signage.
Hinsdale Mall
- Daily deliveries of construction materials and load-out of demolition debris dumpsters.
- Please watch for sidewalk closures, BUPD detail officers, cones, and observe signage.
Interior Work
Main Entrance Lobby
- Escalator touch-ups, adjustments, and punch list work.
- Patching, painting, and final cleaning is ongoing.
Tower A

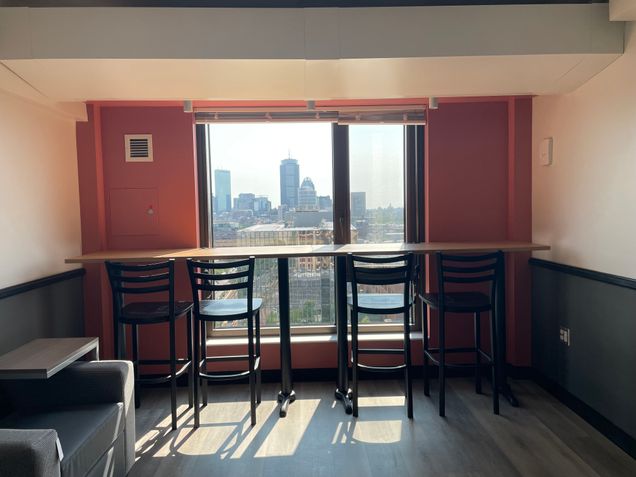

- Lounge furniture delivery and installation of the final remaining items.

Tower B
- Demolition is ongoing. Debris is loaded into hampers, transported, and emptied into dumpsters located in the construction loading dock.
- Abatement is ongoing. Crews are working 2 shifts; debris is loaded into trailers located in the construction loading dock.
- Floor slab coring, cutting, and grinding is ongoing.
- Cutting of the concrete slab edge at every window opening is ongoing.
- Installation of structural steel reinforcement and beam penetrations is ongoing.
- Installation of fire protection sprinkler risers, mains, branch lines, and heads.
- Rough HVAC piping and ductwork.
- Rough plumbing.
Multipurpose Room
- Turnover on Saturday, August 15.
Dining Hall
- Construction is near completion, and punch list work is ongoing.
- Food service stations and equipment installations.
- Staff training and preparation for opening.
- Mechanical systems commissioning.

Parking Garage
- Parking and Temporary Bike Storage will open on Saturday, August 15.

- Electricians will continue running wiring and conduits throughout the parking garage, 1st, 2nd, and 3rd levels.
- Plumbers are installing new equipment, water, and drain lines in the basement, 1st, 2nd, and 3rd levels.
- Concrete and steel structural repair work continues in the parking garage on the 1st, 2nd, and 3rd floors.
- Sprinkler work on all levels will be ongoing.
- Masons are installing block walls in the new bike storage room.
- Excavation and installation of new drainage piping, gas and oil separator equipment in the basement.
During the Week of 8/17/2026
Crews Working 1st & 2nd Shifts
Exterior Work
South Alley
- Concrete and steel structural repair work continues.
Tower A
North, South, East and West Facades
- Flashing tie-in work at exterior wall and podium roof intersections.
Upper Roof
- Mechanical equipment commissioning.
Tower B
North, South, East and West Facades
- Masons will continue with exterior brick veneer restoration work, selective demolition, installation of restoration anchors, air, water, and vapor barriers, new lintels, flashings, and relieving angles.
- Steel stud framing and sheathing exterior window walls and openings.
Upper Roof
- New parapet construction is ongoing.
- Masonry restoration on elevator machine room headhouse.
- Work on structural stub columns.
- Concrete cutting and coring at fresh air duct risers.
Podium A Roof
- Installation of new roofing and flashing systems.
- Start-up, testing, and commissioning of new mechanical equipment.
Podium B Roof
- Installation of new roofing and flashing systems.
- Skylight trim detail work.
- Start-up, testing, and commissioning of new mechanical equipment.

Podium C Roof
- Staging laydown area.
Podium D/Multipurpose Roof
- Staging laydown area.
- Work continues constructing the new Boiler Room.
West Podium Terrace
- Assembly and installation of heat pumps and condensers, piping, and electrical connections.
- HVAC equipment start-up and commissioning.
- Work on the acoustic roof screen assembly is ongoing.
Commonwealth Ave.
- Masons will continue with exterior brick veneer restoration work, selective demolition, installation of restoration anchors, air, water, and vapor barriers, new lintels, flashings, and relieving angles.
Cummington Mall
In and around the fenced area.
- Daily deliveries of construction materials and load-out of demolition debris dumpsters.
- Two-car personnel and materials hoist way in operation for Tower B.
- The elevator operators begin their safety checks and preventative maintenance on the hoist way daily at 6:00 a.m.
Cummington Mall West
- Crews are cleaning, organizing, and preparing to open the road for the academic year.
- Please watch for intermittent closures, BUPD detail officers, cones, and observe signage.
Hinsdale Mall
- Daily deliveries of construction materials and load-out of demolition debris dumpsters.
- Please watch for sidewalk closures, BUPD detail officers, cones, and observe signage.
Interior Work
Tower A
- Turned over and ready for student move-in.


Tower B
- Demolition is ongoing. Debris is loaded into hampers, transported, and emptied into dumpsters located in the construction loading dock.
- Abatement is ongoing. Crews are working 2 shifts; debris is loaded into trailers located in the construction loading dock.
- Floor slab coring, cutting, and grinding is ongoing.
- Cutting of the concrete slab edge at every window opening is ongoing.
- Installation of structural steel reinforcement and beam penetrations is ongoing.
- Installation of fire protection sprinkler risers, mains, branch lines, and heads.
- Rough HVAC piping and ductwork.

- Rough plumbing.
Dining Hall
- Construction is near completion, and punch list work is ongoing.

- Food service stations and equipment installations.
- Staff training and preparation for opening.
- Mechanical systems commissioning.
Parking Garage
- Electricians will continue running wiring and conduits throughout the parking garage, 1st, 2nd, and 3rd levels.

- Plumbers are installing new equipment, water, and drain lines in the basement, 1st, 2nd, and 3rd levels.
- Concrete and steel structural repair work continues in the parking garage on the 1st, 2nd, and 3rd floors.
- Sprinkler work on all levels will be ongoing.
- Masons are installing block walls in the new bike storage room.

- Excavation and installation of new drainage piping, gas and oil separator equipment in the basement.
Future / Notable Tasks
- Preparing owner operations & maintenance manuals.
- The 1st delivery of Tower B exterior windows is scheduled for the end of the month.
- Prefabricated valance piping risers arrive next week.
