Warren Towers Renovation Construction Update – 8/22/2025

General Project Information

  • The first weekday work shift will begin at 7:00 am and end at approximately 3:30 pm, with the second shift beginning at 3:00 pm and ending at 11:00 pm, and the third shift starting at 11:00 pm and ending at 7:00 am. Weekend shifts will start at 7:00 am and end at 4:00 pm.
  • The team is currently in the main renovation phase of the project.
  • Emergency Contacts:
    • Owners Representative – Leftfield Project Management: Corey Davidson – 508-330-8489
    • Contractor Representative – Shawmut Design & Construction: Matt Galloway – 617-413-7758

During the Weekend of 8/23

Exterior Work- Tower A

4th-Floor Podium Roofs

  • Crews will use the low roofs as a laydown area for tools, supplies and materials.

East and West Façades

  • Crews will work on the low roofs, east and west of Tower A.
  • Crews will continue abatement demolition, working in a top-down sequence.
Pictured is the exterior containment.
  • Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.

Front Façade and on Commonwealth Avenue

  • Crews will continue abatement demolition, working in a top-down sequence.
  • Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.

Rear Façade and Back Alley

  • Crews will continue installing overhead protection, staging, shoring, and stair components in the South Alley.
  • Crews will continue abatement demolition, working in a top-down sequence.
  • Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.

Upper Roof

  • Crews will be installing temporary roofing.
  • Crews will continue installing steel stub columns and supports for the new penthouse and roof screening.
  • Crews will continue assembling the new parapet.
The installation of the air vapor barrier.

      West Podium and Terrace Roofs

      • Crews will continue installing temporary roofing membrane.

      Multipurpose Room Roof

      • Crews will continue constructing the new boiler room.
      Pictured is the new boiler room.
      • Masons will continue constructing the new CMU parapet walls.

      Cummington Mall
      (In and around the fenced area)

      • There will be daily deliveries of tools, supplies, and materials to be received at the construction loading dock.
      • The 2-car personnel and materials hoist way operations are underway.

          Hinsdale Mall

          • There will not be work on the street, in order to facilitate undergraduate move-in weekend.
          • The loading dock has been reopened for deliveries and services. The, east exit of the parking garage remains closed; however, the west exit will remain open.

                  Interior Work

                  Tower A

                  • Crews will continue demolition work and will load debris into hampers and transport it to be emptied into dumpsters (located in the construction loading dock).
                  • Abatement is ongoing; debris is loaded into trailers located in the construction loading dock.
                  • Crews will continue grinding the floor slab.
                  • Survey crews are working on setting up benchmarks and lay out points on each floor.
                  • Crews will continue the interior framing of window openings on levels 15 through 18.
                  • Crews will continue cutting the concrete slab edge at every window opening.
                  Pictured is the detail of the slab edge.
                  • Crews will continue installing structural steel reinforcement and beam penetrations.
                  • Crews will continue working on the interior framing of window openings.
                  Pictured is the partition layout.
                  • Crews will be installing fire protection, sprinkler risers, and mains.
                  • Crews will be conducting rough work on HVAC piping and ductwork.
                  Pictured is a mockup of the fresh air riser and smoke damper.
                  • Crews will continue the installation of structural steel clips, plates, kickers and beam penetrations.

                            Parking Garage

                            • There will not be work in the parking garage, in order to facilitate undergraduate move-in weekend. You can read more about the changes and updates to traffic patterns here.

                              During the Week of 8/25

                              Exterior Work- Tower A

                              4th-Floor Podium Roofs

                              • Crews will use the low roofs as a laydown area for tools, supplies and materials.

                              East and West Façades

                              • Crews will work on the low roofs, east and west of Tower A.
                              • Crews will continue abatement demolition, working in a top-down sequence.
                              • Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.
                              • A delivery of windows will arrive on Monday, and crews will begin installing them thereafter.

                              Front Façade and on Commonwealth Avenue

                              • Crews will continue abatement demolition, working in a top-down sequence.
                              • Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.

                              Rear Façade and Back Alley

                              • Crews will continue installing overhead protection, staging, shoring, and stair components in the South Alley.
                              • Crews will continue abatement demolition, working in a top-down sequence.
                              • Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.

                              Upper Roof

                              • Crews will be installing temporary roofing.
                              • Crews will continue installing steel stub columns and supports for the new penthouse and roof screening.
                              • Crews will continue assembling the new parapet.

                                  West Podium and Terrace Roofs

                                  • Crews will continue installing temporary roofing membrane.

                                  Multipurpose Room Roof

                                  • Crews will continue installing the new boiler room.
                                  • Masons will continue constructing the new CMU parapet walls.

                                  Cummington Mall
                                  (In and around the fenced area)

                                  • There will be daily deliveries of tools, supplies, and materials to be received at the construction loading dock.
                                  • The 2-car personnel and materials hoist way operations are underway.
                                  • The team will participate in daily contractor meetings to review site safety, logistics, and the code of conduct.

                                      Hinsdale Mall

                                      • Summer road work has concluded, and the road is back open for normal traffic patterns.
                                      • The loading dock has been reponed for deliveries and services.

                                        Interior Work

                                        Tower A

                                        • Crews will continue demolition work and will load debris into hampers and transport it to be emptied into dumpsters (located in the construction loading dock).
                                        • Abatement is ongoing; debris is loaded into trailers located in the construction loading dock.
                                        • Crews will continue grinding the floor slab.
                                        • Survey crews are working on setting up benchmarks and lay out points on each floor.

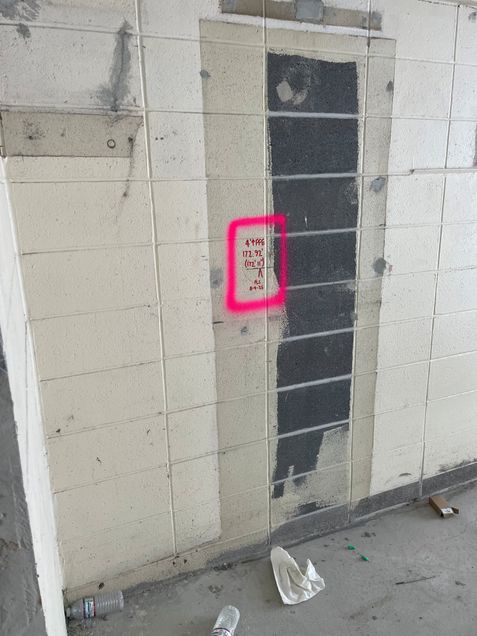

                                        Pictured are the benchmarks.
                                        • Crews will continue the interior framing of window openings on levels 15 through 18.

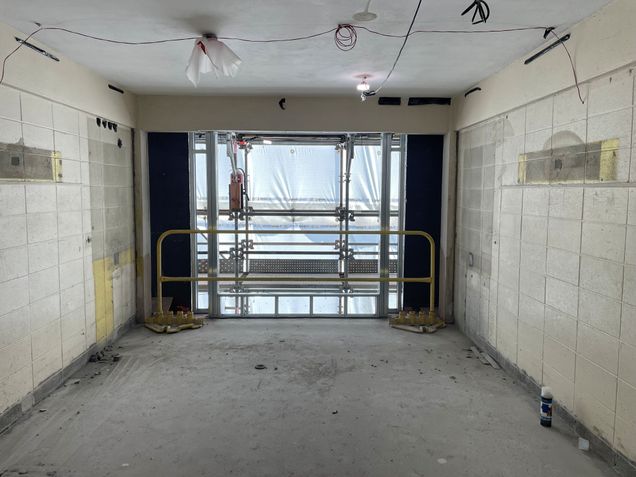

                                        Pictured is work done for window framing.
                                        • Crews will continue cutting the concrete slab edge at every window opening.

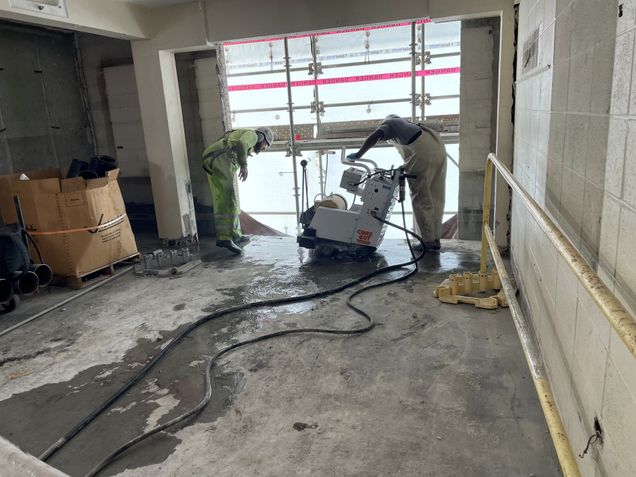

                                        Pictured is crew members cutting the slab edge.
                                        • Crews will continue installing structural steel reinforcement and beam penetrations.
                                        Pictured are some of the steel supports.
                                        • Crews will continue working on the interior framing of window openings.
                                        • Crews will be installing fire protection, sprinkler risers, and mains.
                                        Pictured are the new fire protection risers.
                                        • Crews will be conducting rough work on HVAC piping and ductwork.
                                        • Crews will continue the installation of structural steel clips, plates, kickers and beam penetrations.

                                                Parking Garage

                                                • Crews are constructing the temporary bike storage room.
                                                Pictured is the temporary bike storage room.
                                                • Electricians will be running temporary power wiring and conduits throughout the parking garage, 1st, 2nd, and 3rd levels.
                                                • Plumbers are installing new water and drain lines in the basement, 1st, 2nd, and 3rd levels.
                                                • Crews will continue constructing the new fuel storage room in the Southeast basement level of the parking garage. The tank is scheduled to be installed mid-week.
                                                • Crews will conduct miscellaneous concrete structural repairs on the 1st, 2nd, and 3rd levels of the parking garage.
                                                Pictured are some of the new steel beams.
                                                • Crews will continue sprinkler work on all levels.
                                                • Please watch for adjusted parking patterns, cones and observe site signage.

                                                  Off Site

                                                  • Crews are building detailed interior mockups of bathrooms and student rooms to work through each step for schedule efficiencies and constructability.
                                                  Pictured is a mockup of the renovated bathrooms.

                                                  Future/Notable Tasks

                                                  • Crews will conduct reoccurring crane work on Cummington Mall west in the coming weeks.
                                                  • Crews will begin constructing the new Parking and Transportation offices.
