Warren Towers Renovation Construction Update – 8/15/2025
General Project Information
- The first weekday work shift will begin at 7:00 am and end at approximately 3:30 pm, with the second shift beginning at 3:00 pm and ending at 11:00 pm, and the third shift starting at 11:00 pm and ending at 7:00 am. Weekend shifts will start at 7:00 am and end at 4:00 pm.
- The team is currently in the main renovation phase of the project.
- Emergency Contacts:
- Owners Representative – Leftfield Project Management: Corey Davidson – 508-330-8489
- Contractor Representative – Shawmut Design & Construction: Matt Galloway – 617-413-7758
During the Weekend of 8/16
No work planned to take place Sunday 8/17
Exterior Work- Tower A
4th-Floor Podium Roofs
- Crews will use the low roofs as a laydown area for tools, supplies and materials.
East and West Façades
- Crews will work on the low roofs, east and west of Tower A.
- Crews will continue abatement demolition, working in a top-down sequence.

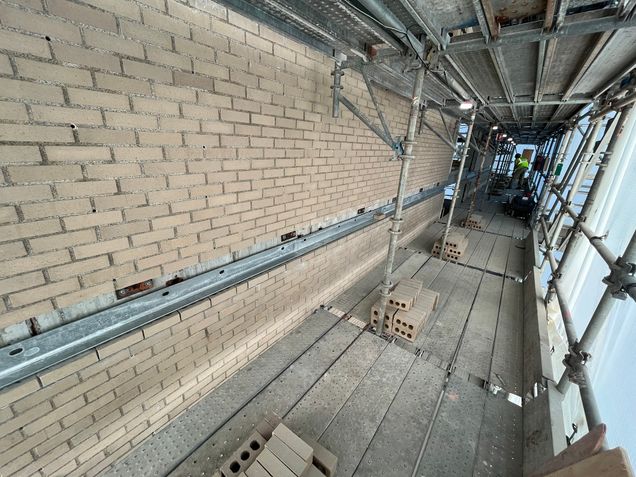

- Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.

Front Façade and on Commonwealth Avenue
- Crews will continue abatement demolition, working in a top-down sequence.
- Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.
Rear Façade and Back Alley
- Crews will continue installing overhead protection, staging, shoring, and stair components in the South Alley.
- Crews will continue abatement demolition, working in a top-down sequence.
- Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.
Upper Roof
- Crews will be installing temporary roofing.
- Crews will continue installing steel stub columns and supports for the new penthouse and roof screening.
West Podium and Terrace Roofs
- Crews will continue installing temporary roofing membrane.
- Masons will begin constructing the new CMU parapet walls.
Multipurpose Room Roof

- Crews will continue constructing the new boiler room.

Cummington Mall
(In and around the fenced area)
- There will be daily deliveries of tools, supplies, and materials to be received at the construction loading dock.
- The 2-car personnel and materials hoist way operations are underway.
- The team will participate in daily contractor meetings to review site safety, logistics, and the code of conduct.

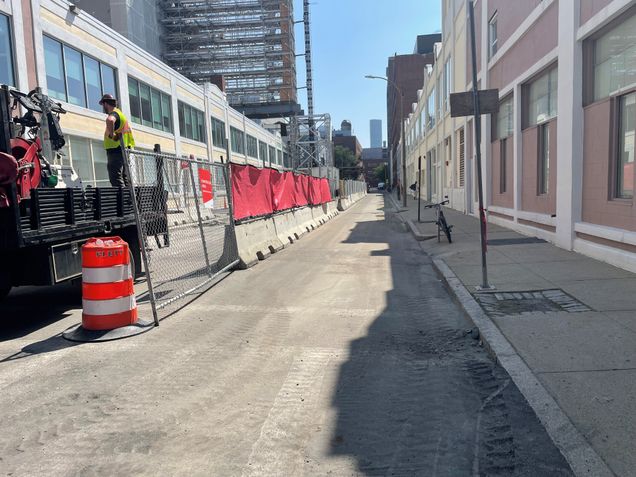

- Crews have pulled back the jersey barriers and fence line to open Cummington Mall to through traffic.

Hinsdale Mall

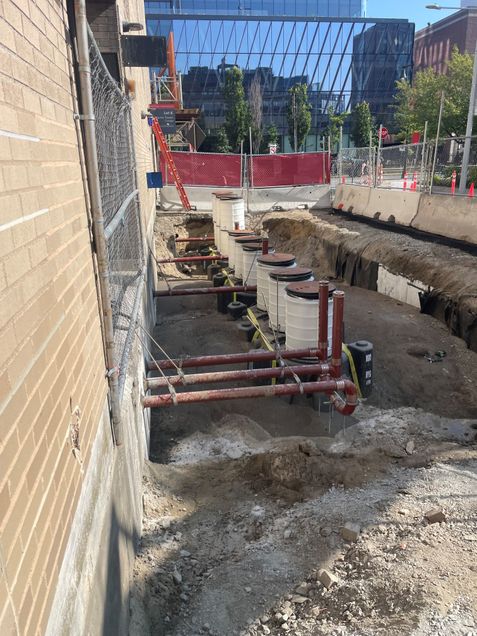

- Crews will continue installing the new grease trap system, through the replacement of concrete sidewalks and bituminous pavement, and with backfilling.

- The loading dock has been reopened for deliveries and services. The, east exit of the parking garage remains closed; however, the west exit will remain open.
Interior Work
Tower A
- Crews will continue demolition work and will load debris into hampers and transport it to be emptied into dumpsters (located in the construction loading dock).
- Abatement is ongoing; debris is loaded into trailers located in the construction loading dock.

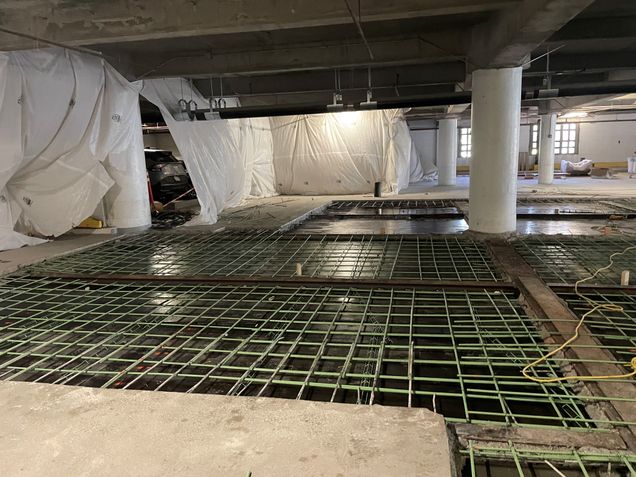

- Crews will continue grinding the floor slab.
- Survey crews are working on setting up benchmarks and lay out points on each floor.
- Crews will continue the interior framing of window openings on levels 15 through 18.
- Crews will continue cutting the concrete slab edge at every window opening.

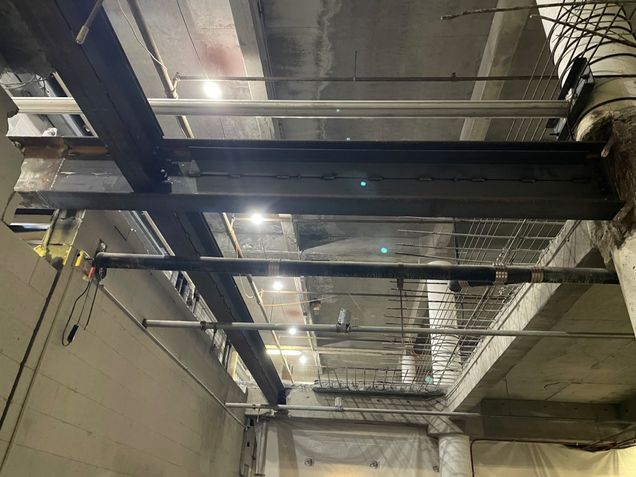

- Crews will continue installing structural steel reinforcement and beam penetrations.
- Crews will continue working on the interior framing of window openings.
- Crews will be conducting rough work on the sprinklers.
- Crews will continue the installation of structural steel clips, plates, kickers and beam penetrations.
4th-Floor Podium Level
(Corridors, security areas, study areas, and the multipurpose room)
- Crews are completing the final drywall patching, painting, touchups, and cleaning.
Parking Garage

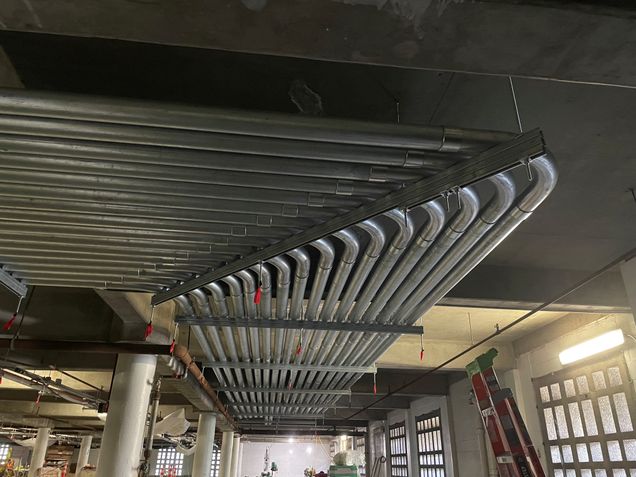

- Electricians will be running temporary power wiring and conduits throughout the parking garage, 1st, 2nd, and 3rd levels.
- Plumbers are installing new water and drain lines in the basement, 1st, 2nd, and 3rd levels.

- Crews will continue constructing the new fuel storage room in the Southeast basement level of the parking garage.
- Crews will conduct miscellaneous concrete structural repairs on the 1st, 2nd, and 3rd levels of the parking garage.

- Crews will continue sprinkler work on all levels.
- Please watch for adjusted parking patterns, cones and observe site signage.
Lobby

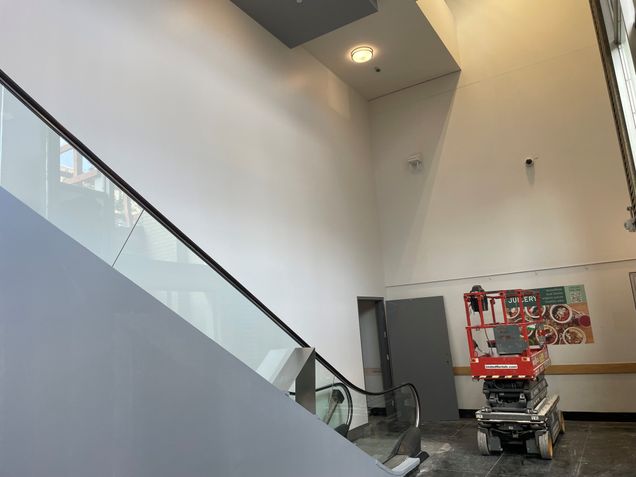

- Crews will conduct ongoing electrical work within the new fire command center.
During the Week of 8/18
Exterior Work- Tower A
4th-Floor Podium Roofs
- Crews will use the low roofs as a laydown area for tools, supplies and materials.
East and West Façades
- Crews will work on the low roofs, east and west of Tower A.
- Crews will continue abatement demolition, working in a top-down sequence.
- Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.
Front Façade and on Commonwealth Avenue
- Crews will continue abatement demolition, working in a top-down sequence.
- Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.
Rear Façade and Back Alley
- Crews will continue installing overhead protection, staging, shoring, and stair components in the South Alley.
- Crews will continue abatement demolition, working in a top-down sequence.
- Masons will continue with their exterior brick veneer restoration work, selective demolition, installation of restoration anchors, new lintels, and relieving angles.
Upper Roof

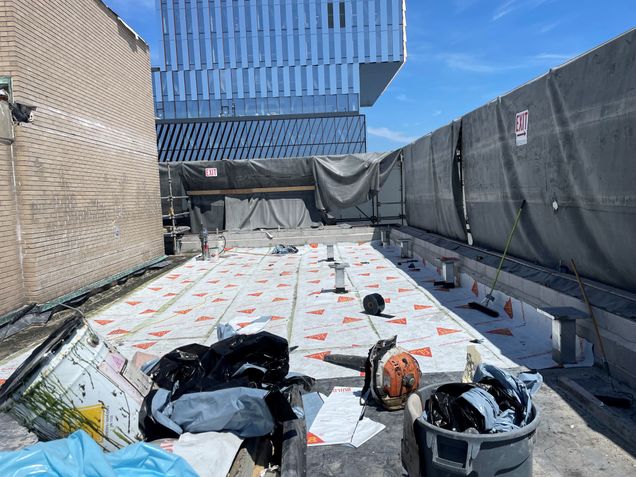

- Crews will be installing temporary roofing.

- Crews will continue installing steel stub columns and supports for the new penthouse and roof screening.
West Podium and Terrace Roofs
- Crews will continue installing temporary roofing membrane.
- Masons will begin constructing the new CMU parapet walls.
Multipurpose Room Roof
- Crews will continue installing the new boiler room.
Cummington Mall
(In and around the fenced area)
- There will be daily deliveries of tools, supplies, and materials to be received at the construction loading dock.
- The 2-car personnel and materials hoist way operations are underway.
- The team will participate in daily contractor meetings to review site safety, logistics, and the code of conduct.
- Crews have pulled back the jersey barriers and fence line to open Cummington Mall to through traffic.
Hinsdale Mall
- Crews will continue installing the new grease trap system, through the replacement of concrete sidewalks and bituminous pavement, and with backfilling.
- The loading dock has been reopened for deliveries and services. The, east exit of the parking garage remains closed; however, the west exit will remain open.
Interior Work
Tower A
- Crews will continue demolition work and will load debris into hampers and transport it to be emptied into dumpsters (located in the construction loading dock).
- Abatement is ongoing; debris is loaded into trailers located in the construction loading dock.
- Crews will continue grinding the floor slab.
- Survey crews are working on setting up benchmarks and lay out points on each floor.
- Crews will continue the interior framing of window openings on levels 15 through 18.
- Crews will continue cutting the concrete slab edge at every window opening.
- Crews will continue installing structural steel reinforcement and beam penetrations.
- Crews will continue working on the interior framing of window openings.

- Crews will be conducting rough work on the sprinklers.
- Crews will continue the installation of structural steel clips, plates, kickers and beam penetrations.
4th-Floor Podium Level
(Corridors, security areas, study areas, and the multipurpose room)
- Crews are completing the final drywall patching, painting, touchups, and cleaning.
Parking Garage
- Electricians will be running temporary power wiring and conduits throughout the parking garage, 1st, 2nd, and 3rd levels.

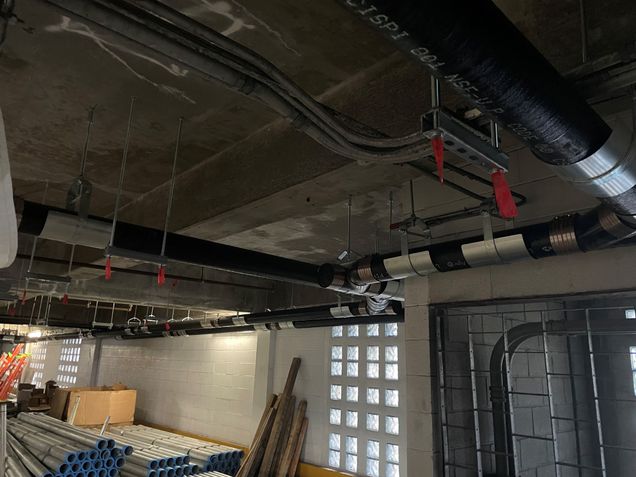

- Plumbers are installing new water and drain lines in the basement, 1st, 2nd, and 3rd levels.

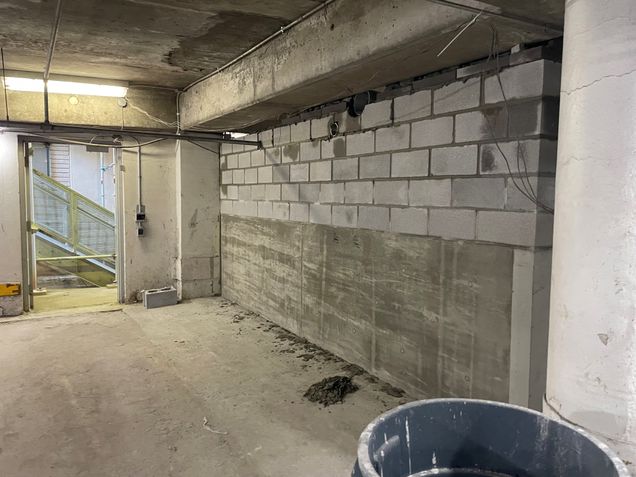

- Crews will continue constructing the new fuel storage room in the Southeast basement level of the parking garage.

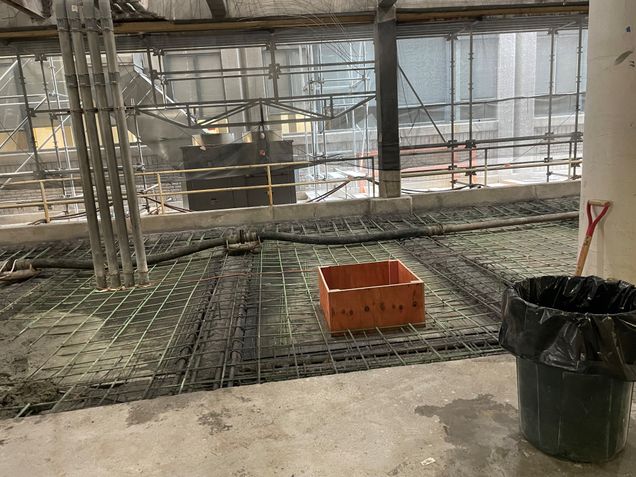

- Crews will conduct miscellaneous concrete structural repairs on the 1st, 2nd, and 3rd levels of the parking garage.

- Crews will continue sprinkler work on all levels.
- Please watch for adjusted parking patterns, cones and observe site signage.
Lobby
- Crews will conduct ongoing electrical work within the new fire command center.

Off Site

- Crews are building detailed interior mockups of bathrooms and student rooms to work through each step for schedule efficiencies and constructability.

Future/Notable Tasks
- Crews will conduct reoccurring crane work on Cummington Mall west in the coming weeks.
- Crews will be reopening Hinsdale Mall.
- Crews will begin framing the interior walls and soffits in Tower A.
- Crews will begin rouch mechanical, electrical, plumbing and fire protection work in Tower A.
- The first shipment of new exterior window units will be delivered to the site.
- Crews will begin constructing the new Parking and Transportation offices.
