Kilachand Hall Phase 2 – Construction Update – 11/18/22

General Project Information

Kilachand Hall site plan during the course of construction.
  • Daily Work Hours from 7 am – 3:30 pm.
  • The Traffic Management Plan for the project has been approved by the Boston Transportation Department and is in place.
  • Relocated accessible parking spaces posted for use on 6/29 (in front of 81 and 83 Bay State Road).
  • Jersey barrier site containment in place, pedestrian walkway also in place and operational. City sidewalk in front of Kilachand Hall is permitted to be used as part of the construction site limits.
  • Bike lane is fully functional in front of Kilachand Hall
  • BU parking spots directly behind Kilachand Hall on Back Street remain a “no parking zone”. This will continue for the duration of the project to maintain an adequate drive lane for local traffic on Back Street and allowing for the construction team to safely contain a work area north of the dormitory

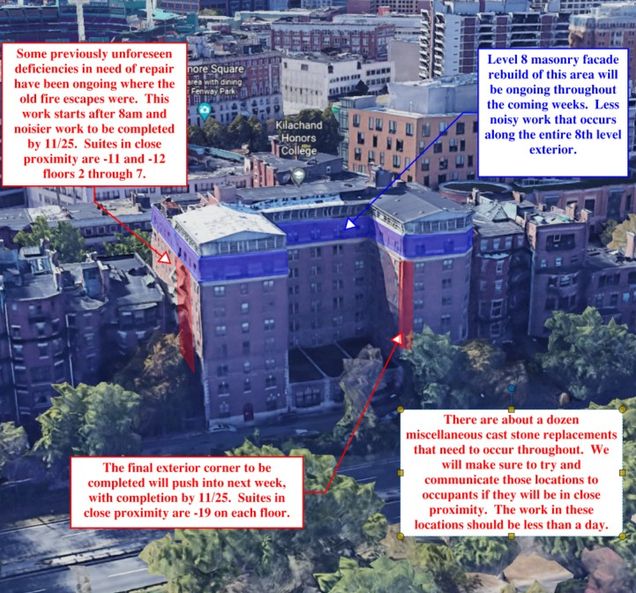

North elevation update

South elevation update

During the week of November 21st

    • No work will take place on Thursday, November 24. The site will return to normal work hours on Friday, November 25.
    • Due to some unforeseen conditions that must be addressed before winter, some of the noisier work has progressed further into November than expected. The team is hoping to be off the exterior of occupied floors after next week. Any one-off activities that come up will continue to be communicated to the occupants affected.
    • Titan Roofing crew to be on site to install roofing and parapet cap at small roofs on the south elevation of floor 7 (see photo above for locations). The suite in proximity is suite 709.
    • Riggs masonry (see photo above for locations of work):
      • Masons continue with masonry backup repairs on the level 8 façade, in preparation for brick rebuild. The 8th level is unoccupied.
      • There will be some miscellaneous cast stone pieces being replaced throughout the façade in various locations. These replacements tend to be quick and no longer than a day in each location. If in proximity to occupied rooms, work will be communicated ahead of time.
      • The team will continue on the last exterior corner rebuild, with brickwork starting this week and continuing into next week for completion. 10 of the 11 corners have been finished.
        • Suites in close proximity and most affected by noise will be suite 19 on each floor. The team is starting on level 2 this week.
      • The masonry crew also continues with the construction of the concrete parapet wall on level 9, with completion expected in the coming weeks.

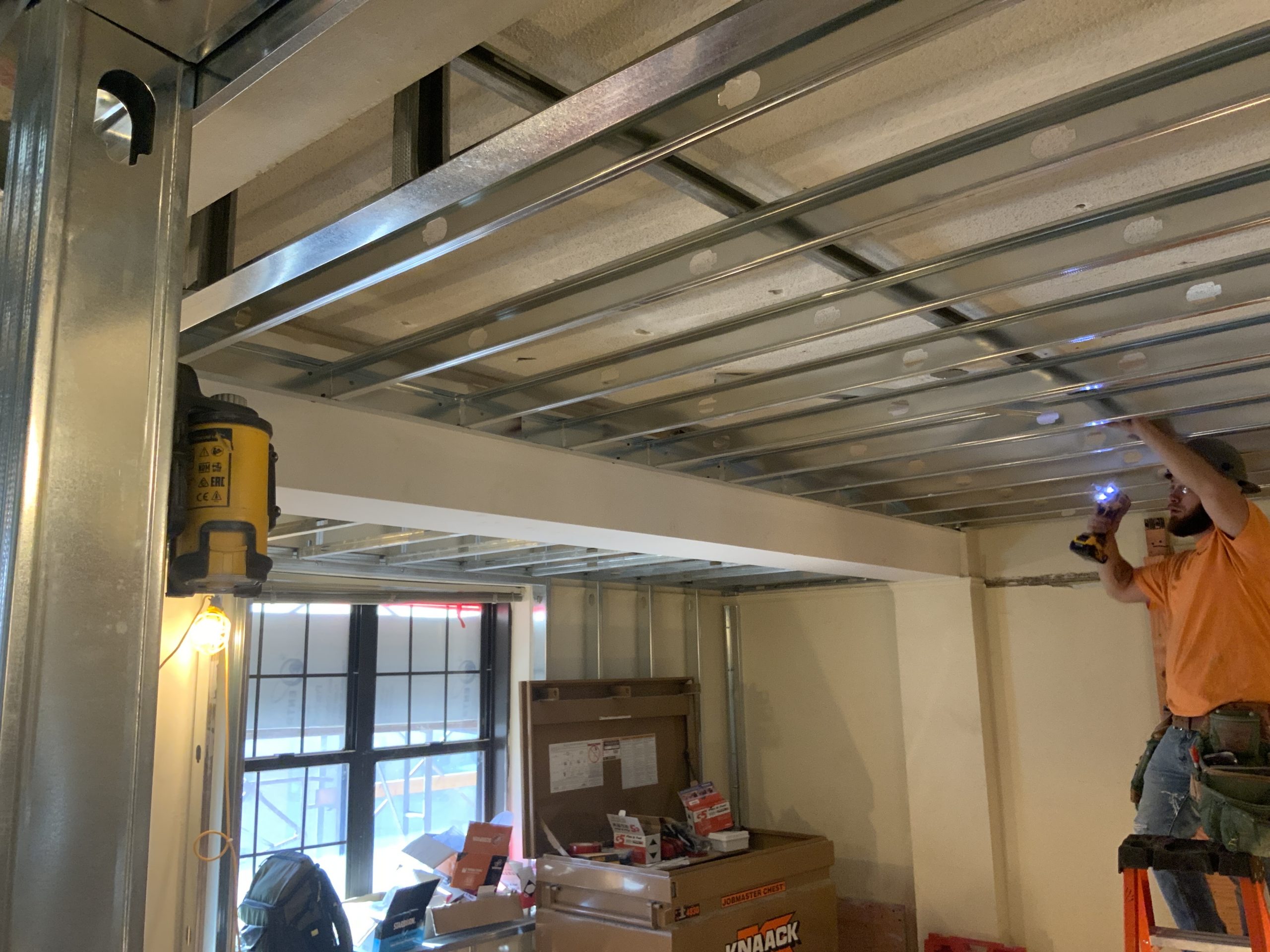

    • Mass Acoustics to continue framing in contained renovation areas on all floors.
    • Royal Steam Plumbing and HVAC continue with rough in work on all floors.
    • Cogswell fire sprinkler working on rough piping in contained work area on all floors.
    • Murphy Electric continues with rough electric work in all areas.
    • Riggs Contracting carpenters and laborers to continue with temporary winter protections throughout 9th floor as needed.
    • Consigli/Riggs team on site for cleaning support and supervision.
