Center for Computing & Data Sciences – Construction Update – 10/8/21

During the weekend of October 9th

  • There will be no work on site Saturday or Sunday.

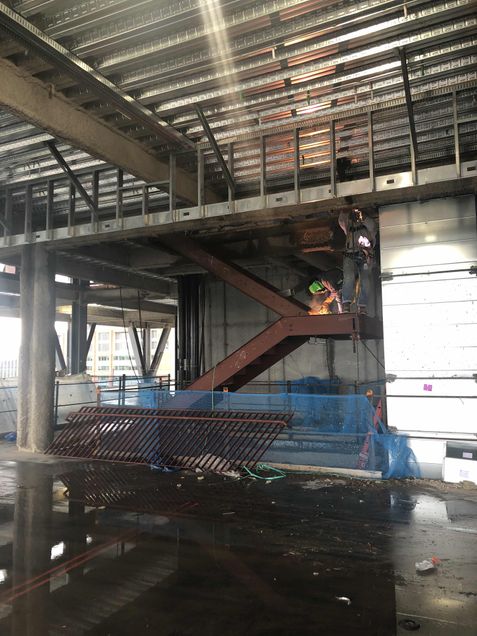

Installing Stair B from level 8 to 9

During the week of October 11th

  • There will be no work on site Monday, October 11th.
  • Erection of the building’s structural steel frame has been completed. Bolting and detailing on the 15th through 20th floors continues.
  • Installation of the building’s stairs will continue to follow the structural steel operation. “Stair B”, located north of the tower’s core, will continue through the 13th floor. Installation of “Stair C”, located at the east end of the podium, will continue through the 5th floor. Concrete placements of the stair treads will occur as the floors become available.
  • Final detailing, setting rebar, installing wire mesh, and sleeving for MEP penetrations will occur in advance of a concrete placement for the tower’s 15th and 16th floors.
  • Installation of curtain wall panels will continue on the podium’s 4th floor. Deliveries of curtain wall panels will continue through the week, and panel preassembly will progress on the floors before installing in place.
  • In the tower’s subbasement and lower level, crews from the mechanical, electrical, and plumbing subcontractors will continue installing electrical wiring, hangers, piping, and equipment for the building systems. Partition drywall installation will continue.
  • On the 2nd through 11th floors of the tower, the mechanical, electrical, and plumbing subcontractors will continue installing electrical conduit, hangers, and piping.
  • Crews will be applying a fireproof coating on the interior steel beams and columns for the tower’s 11th and 12th floor framing (working from the 10th and 11th floors respectively) and a white fireproof coating on the exterior columns for the 3rd and 4th floors.
  • The elevator subcontractor will mobilize to the site to begin installation of the rails for elevators 4, 5, and 6, located on the south side of the tower’s core.
  • In addition to deliveries noted above other trucking activity to and from the site will be occurring daily with trucks entering and exiting the designated gates.

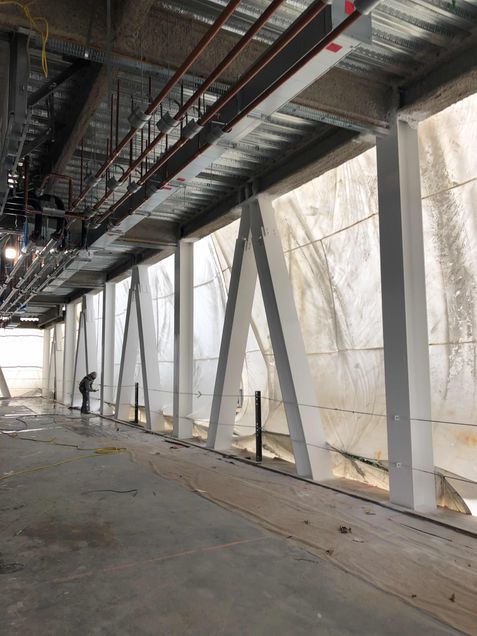

Applying intumescent coating to the towers 4th floor steel
Applying an intumescent coating to the tower’s 4th-floor steel
