Geothermal Well Drilling Initiative – Construction Update – 11/01/19

During the week of November 4th:

Parking Lot N

  • The drilling subcontractor will continue drilling at GT-5 and anticipates moving to complete drilling at GT-4.
  • The site subcontractor will be handling the soil material in the settlement basin for removal and transportation to the disposal facility. They will also be power washing the roll-off tank within the fenced in area.
  • Water from the storage tanks will continue to be tested periodically and discharged into the storm water drainage system upon acceptance from the testing agent.

Alleyway

  • The subcontractor will be using a vacuum excavation truck to remove sediment from the dewatering tanks in the alley and will transfer the material into the settlement basin within parking Lot N.

Park

  • The site subcontractor will be setting concrete structures and covers at GT-7 & GT-27.
  • Construction equipment will be making periodic trips into the fenced area of the park to access the stockpiled materials.

As a reminder to all, please be aware of all directional signage, as pedestrian travel paths may be altered. Your safety is imperative!

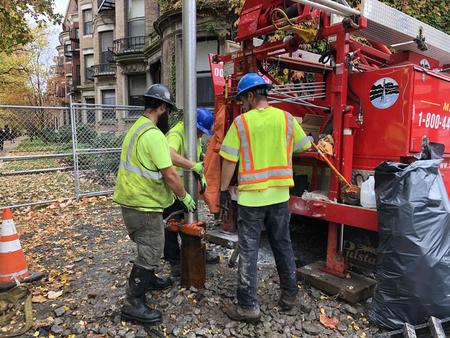

High-performance geothermal exchange vertical piping installation at GT-7
High-performance geothermal exchange vertical piping installation at GT-7
