Geothermal Well Drilling Initiative – Construction Update – 3/22/19

During the week of March 25:

Park Test Well #3

  • Driller has mobilized and drilled 225 feet through the overburden, installed and grouted the casing on 3/21.
  • This week, starting on 3/25, the drilling contractor anticipates continuing with the mud rotary drilling into bedrock at geothermal test well #3. A water tank truck will periodically be crossing Granby St. to access the hydrant on Bay State Rd.
  • The drilling operations will be ongoing between 9 am and 5:30 pm and we anticipate higher than usual daily noise levels over the next two weeks.

As a reminder to all, please be aware of all directional signage, as pedestrian travel paths may be altered. Your safety is imperative!

“Mud puppy” mixes slurry and removes cuttings for at TW#3
“Mud puppy” mixes slurry and removes cuttings at TW#3

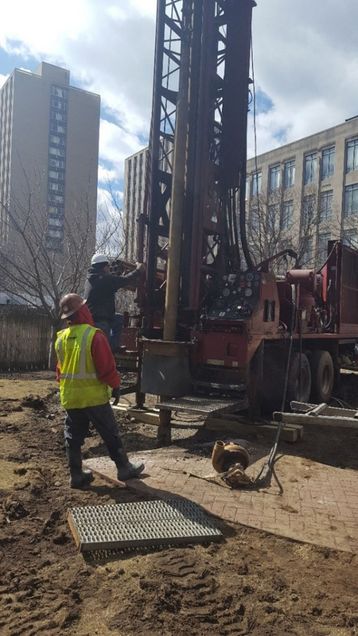

Overburden drilling at TW#3
Overburden drilling at TW#3
