Myles Standish Hall – Construction Activity – 6/18/16 to 6/24/16

For 6/18/16 – 6/24/16:

Deliveries

  • Subcontractors will receive deliveries all week from 7 a.m. to 5 p.m. on both Beacon Street and Bay State Road.



Onsite Construction

No work – Saturday 06/18/16

Man and Material Hoist Construction

  • Excavate for hoist pad on Bay State Road side of building – Exterior
  • Form and pour hoist pad on Bay State Road side of building – Exterior



Demolition Abatement

  • Load out at Beacon Street – Load out demolition debris from 1st floor to dumpster.
  • Continue with load out down chute – Interior
  • Demolition and load out of basement.
  • Demolition after abatement at buffer zone on floors 5 and 6.
  • Demolition of floors 8 and 9.
  • Start demolition of existing freight elevator shaft – Interior



Masonry Restoration (Exterior)

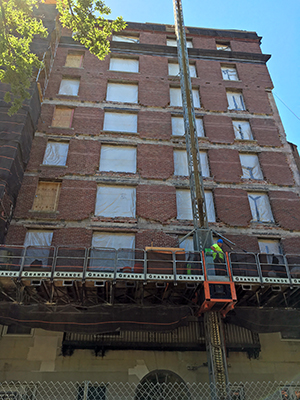

  • Continue with removal of windows on the Bay State Road side of the building.
  • Continue with masonry demo on the Bay State Road side of the building.
  • Start installation of staging on the Beacon Street side of the building.
  • Start removal of windows on the Beacon Street side of the building.



Roof (Exterior)

  • Continue with demolition of roof curbs and penthouse, and installation of temporary roof curbs.



Site Work

  • Start excavation for transformer pad foundation in the alley – Excavator and trucks for load out of dirt.

Myles 6/17/16 Myles 6/17/16

For questions, please contact Brian Kelley.
