Warren Towers Renovation Construction Update – 1/30/2026
General Project Information
- Weekday shifts run from 7:00 a.m. to 3:30 p.m. (1st shift), 9:00 a.m. to 5:00 p.m. (1st shift for work outside/adjacent to student rooms), 3:00 p.m. to 11:00 p.m. (2nd shift), and 11:00 p.m. to 7:00 a.m. (3rd shift). Weekend shifts operate from 7:00 a.m. to 5:00 p.m.
- The team is currently in the main renovation phase of the project.
- Emergency Contacts:
- Owner’s Representative – Leftfield Project Management: Corey Davidson – 508-330-8489
- Contractor Representative – Shawmut Design & Construction: Matt Galloway – 617-413-7758
During the weekend of 1/31–2/1
Saturday (1st shift) | Sunday (1st, 2nd, 3rd shift) clearing snow and ice
Exterior Work
Tower A
4th Floor Podium Roofs
- Low roofs will be used as laydown areas for tools, supplies, and materials.
East & West Facades
- Masons will continue exterior brick veneer restoration work, including selective demolition and installation of restoration anchors, air-, water-, and vapor-barrier systems, new lintels, flashings, and relieving angles.
Front Façade and on Commonwealth Ave.
- Masons will continue exterior brick veneer restoration work, including selective demolition and installation of restoration anchors, air-, water-, and vapor-barrier systems, new lintels, flashings, and relieving angles.
Rear Façade and Back Alley
- Masons will continue exterior brick veneer restoration work, including selective demolition and installation of restoration anchors, air-, water-, and vapor-barrier systems, new lintels, flashings, and relieving angles.
Upper Roof
- Work continues constructing the new mechanical penthouse and emergency electric room.
- Assembly and installation of the DOAS unit, piping, sheet metal ductwork, and electrical connections continue.

Tower B
North, south, east, and west facades
- Staging crews will load the materials onto the lower roofs on Saturday with a crane.


West Podium Terrace
- Assembly and installation of heat pumps and condensers, including piping and electrical connections, continues on the mechanical platform.
Multipurpose Room Roof (Podium D)
- Work continues constructing the new boiler room.

Cummington Mall
(In and around the fenced area)
- Daily deliveries of tools, supplies, and materials will be received at the construction loading docks within the fenced area.
- Two-car personnel and materials hoist way remains in operation.
- (Elevator operators begin daily safety checks and preventative maintenance at 6:00 a.m.)
- Tower B hoist way bridge construction is ongoing.

Cummington Mall West/Hinsdale Mall
- BUPD detail officers and construction staff will be on-site to assist with pedestrian and vehicular traffic.
Interior Work
Tower A
- Steel stud framing of interior partitions and soffits continues.
- Installation of hollow metal door frames continues.
- Drywall installation and taping continues.
- New window installation continues.
- Plaster patching at columns and beams continues.
- Installation of fire protection sprinkler risers, mains, branch lines, and heads continues.
- Rough-in of HVAC piping, electrical, fire alarm, plumbing, and sheet metal ductwork continues.

Pictured is the installation of heating and cooling units in Tower A student rooms.
- Pressure testing of mechanical piping and sheet metal ductwork continues.
- Installation of structural steel clips, plates, kickers, and beam penetrations continues.
- Stair handrail and riser alterations are ongoing.
- Priming and painting of walls, ceilings, soffits, doors, and door frames continues.
- Application of spray fireproofing, expanding foam insulation, and firestopping continues.
- Modernization of the Tower elevators by Otis Elevator Company continues.

Parking Garage
- Electricians continue running wiring, conduits, and electrical gear throughout Levels 1–3.

- Plumbers continue installing new water and drain lines in the basement and Levels 1–3.

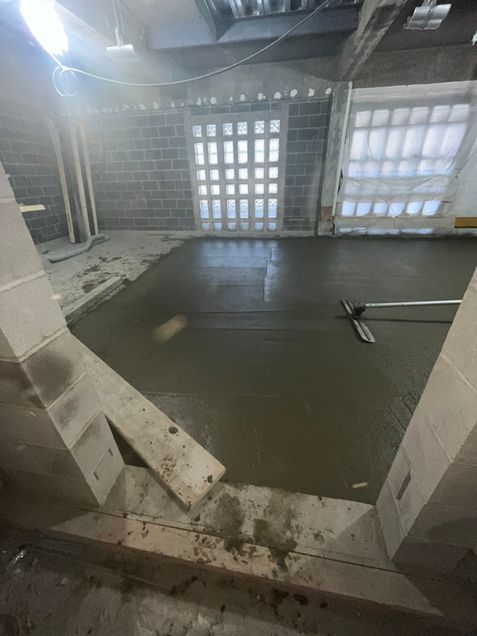

- Concrete and steel structural repairs continue on Levels 1–3.

- Sprinkler work continues on basement and Levels 1–3.
- Masons continue installing block walls in the new mechanical and electrical rooms.
- Please watch for adjusted parking patterns, cones, and observe signage.
During the week of 2/2
Crews working 1st & 2nd shifts
Exterior Work
Tower A
4th Floor Podium Roofs
- Low roofs will be used as laydown areas for tools, supplies, materials, and temporary heating units.
East & West Facades
- Crews will be working on the low roofs east and west of Tower A.
- Masons will continue exterior brick veneer restoration work, including selective demolition and installation of restoration anchors, air-, water-, and vapor-barrier systems, new lintels, flashings, and relieving angles.
- Installation of new windows and metal panels continues.

Front Façade and on Commonwealth Ave.
- Masons will continue exterior brick veneer restoration work, including selective demolition and installation of restoration anchors, air-, water-, and vapor-barrier systems, new lintels, flashings, and relieving angles.
- Installation of new windows and metal panels continues.
Rear Façade and Back Alley
- Masons will continue exterior brick veneer restoration work, including selective demolition and installation of restoration anchors, air-, water-, and vapor-barrier systems, new lintels, flashings, and relieving angles.
- Installation of new windows and metal panels continues.
Upper Roof
- Work continues constructing the mechanical penthouse and emergency electric room.
- Assembly and installation of DOAS units, piping, sheet metal ductwork, and electrical connections continue.
Tower B
- Scaffolding installation continues on all façades. The crews will be working on levels 5-9 next week.

West Podium Terrace
- Assembly and installation of heat pumps and condensers continue.
- Piping and electrical connections on mechanical platforms continues

- Carpenters will be installing roof screen steel stud framing.
Multipurpose Room Roof (Podium D)
- Work continues constructing the new boiler room.
Cummington Mall
(In and around the fenced area)
- Daily deliveries of tools, supplies, and materials will continue.
- Two-car personnel and materials hoist way remains in operation.
- (Elevator operators begin daily safety checks and preventative maintenance at 6:00 a.m.).
- Temporary elevator hoist way and bridge beam assembly for Tower B continues and impacts two entry/exit doors at 111 Cummington Mall.
Cummington Mall West / Hinsdale Mall
- BUPD detail officers and construction staff will be on-site.
Interior Work
Tower A
- Steel stud framing of interior partitions and soffits continues.
- Installation of hollow metal door frames continues.
- Drywall installation and taping continue.
- New window installation continues.
- Plaster patching continues.
- Sprinkler installation continues.
- Rough-in of MEP systems continue.
- Pressure testing continues.
- installation of structural steel clips, plates, kickers and beam penetrations continues.
- Stair alterations continue.

- Priming and painting of walls, ceilings, soffits, doors, and door frames continues.
- Fireproofing and firestopping continues.
- Otis elevator modernization continues.

- Third-party inspectors remain onsite as needed.
Parking Garage
- Work continues in the main electrical room.
- Electricians will continue running wiring and conduits throughout the parking garage on levels 1-3.

- Electrical bus duct riser installation for Tower A continues.
- Installation of electrical gear continues.
- Plumbers will continue installing new water and drain lines in the basement and levels 1-3.
- Mechanical piping installation continues.
- Parking & Transportation office construction continues.

- Fuel storage room construction continues.
- Concrete and steel structural repair work continues on levels 1-3.
- Work on sprinklers continues
- Masons will continue installing block walls in the new mechanical and electric rooms.
- Temporary heaters remain in operation on Level 3.
- Please watch for adjusted parking patterns, BUPD detail officers, cones, and observe signage.
Future / Notable Tasks
- Crane lift of emergency generator up onto Tower A roof 2/7.
- Crane lift mechanical equipment onto West Terrace on 2/10.
- 1st delivery of interior doors and hardware on 2/11.
- Continuing window leak testing on Tower A.
- Ceramic tile installation will begin on the second week of February.
- Continue performing FM Global Roof Uplift Testing on all roofs.
