Warren Towers Renovation Construction Update – 12/19/2025
General Project Information
- Weekday shifts run from 7:00 a.m. to 3:30 p.m. (1st shift), 3:00 p.m. to 11:00 p.m. (2nd shift), and 11:00 p.m. to 7:00 a.m. (3rd shift). Weekend shifts operate from 7:00 a.m. to 5:00 p.m.
- The team is currently in the main renovation phase of the project.
- Emergency Contacts:
- Owner’s Representative – Leftfield Project Management: Corey Davidson – 508-330-8489
- Contractor Representative – Shawmut Design & Construction: Matt Galloway – 617-413-7758
During the weekend of 12/20–12/21
Saturday (1st & 2nd shifts) | Sunday (1st, 2nd & 3rd shifts)
Exterior Work – Tower A
4th Floor Podium Roofs
- Low roofs will be used as laydown areas for tools, supplies, and materials.
East & West Facades
- Masons will continue exterior brick veneer restoration work, including selective demolition and installation of restoration anchors, air-, water-, and vapor-barrier systems, new lintels, flashings, and relieving angles.
Front Façade and on Commonwealth Ave.
- Masons will continue exterior brick veneer restoration work, including selective demolition and installation of restoration anchors, air-, water-, and vapor-barrier systems, new lintels, flashings, and relieving angles.
Rear Façade and Back Alley
- Masons will continue exterior brick veneer restoration work, including selective demolition and installation of restoration anchors, air-, water-, and vapor-barrier systems, new lintels, flashings, and relieving angles.
Upper Roof
- Work continues constructing the new mechanical penthouse.
- Iron workers continue assembling steel beams and grating at the new rooftop mechanical platform and roof screen supports.
West Podium Terrace
- Iron workers are assembling galvanized steel beams, columns, and grating for the mechanical platform and roof screen supports.
Multipurpose Room Roof (Podium D)
- Work continues constructing the new boiler room.
Cummington Mall
(In and around the fenced area)
- Daily deliveries of tools, supplies, and materials will be received at the construction loading docks within the fenced area.
- Crews are assembling the four-post hoist way structure and bridge beams for Tower B.
- Two-car personnel and materials hoist way in operation.
- (Elevator operators begin daily safety checks and preventative maintenance at 6:00 a.m.)
Cummington Mall West
- Eversource is installing a new primary electrical service.
- BUPD detail officers and construction staff will be on-site to assist with pedestrian and vehicular traffic.

Hinsdale Mall
- Underground utility work will be ongoing in front of the parking garage entrance.
- Warren Towers Garage (Lot K) – Temporary Closure: The garage will be closed to vehicle entry from Sunday, December 21, at 9:00 p.m. through Wednesday, December 24, at 5:00 a.m. Vehicles parked inside may exit via the west exit (FedEx side) but will not be able to re-enter. The bicycle storage area will remain open.
Interior Work – Tower A
- Steel stud framing of interior partitions and soffits is ongoing.
- Installation of hollow metal door frames continues.
- New window installation continues.
- Plaster patching at columns and beams continues.
- Installation of fire protection sprinkler risers, mains, branch lines, and heads continues.

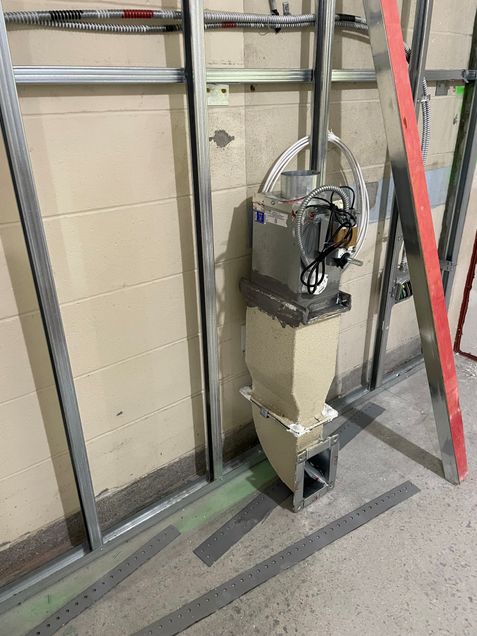

- Rough-in of HVAC piping, electrical, fire alarm, plumbing, and sheet metal ductwork is ongoing.

- Pressure testing of mechanical piping and sheet metal ductwork continues.

- Installation of structural steel clips, plates, kickers, and beam penetrations is ongoing.
- Application of spray fireproofing, expanding foam insulation, and firestopping continues.
During the Winter Intersession (12/22/25–1/9/26)
Crews will be working 1st, 2nd, and 3rd shifts
Exterior Work
Tower A
- Low podium roofs will be used as laydown areas for tools, supplies, materials, and temporary heating units.
- Masons will continue exterior brick veneer restoration work, including selective demolition and installation of restoration anchors, air-, water-, and vapor-barrier systems, new lintels, flashings, and relieving angles.
- Installation of new windows and metal panels continues.

Upper Roof
- Work continues constructing the new mechanical penthouse.
- Iron workers continue assembling galvanized steel beams, columns, and grating for the mechanical platform and roof screen supports.
Tower B
- Exterior scaffolding installation is ongoing.
- Selective demolition of brick veneer and installation of bridge beam angles continues.
- Bridge beams will be installed via crane on Cummington Mall.
West Podium Terrace
- Iron workers are assembling galvanized steel beams, columns, and grating for the mechanical platform and roof screen supports.

- Mechanical equipment will be placed on the platform via crane.
Multipurpose Room Roof (Podium D)
- Work continues constructing the new boiler room.
- Crews are assembling prefabricated mechanical equipment and piping.
Cummington Mall
(In and around the fenced area)
- Daily deliveries of tools, supplies, and materials will continue.
- Crews will continue assembling the temporary elevator hoist way and bridge beams for Tower B. This work impacts two entry/exit doors at 111 Cummington Mall. Please observe site signage for adjusted egress routes.


Cummington Mall West
- The roadway has been converted to two-way traffic.
- A crane will be set up on January 5, 2026, to hoist mechanical equipment to the west terrace.
- BUPD detail officers and construction staff will be on-site to assist with pedestrian and vehicular traffic.
Hinsdale Mall
- Underground utility work will continue in front of the parking garage entrance.
- A crane will be on Hinsdale Mall from December 22–24, 2025, hoisting mechanical equipment into the Tower A mechanical penthouse.

- A crane will return on January 12, 2026, to hoist mechanical equipment onto the Tower A rooftop platform.
- Open-top dumpsters will be placed on Hinsdale Mall while the loading dock is closed.
- BUPD detail officers and construction staff will be on-site.
Commonwealth Ave.
- Eversource and its contractor will be working at Cummington Mall West and Commonwealth Avenue installing the new incoming electrical service.
- Underground utility work on the sidewalk will include installation of new water and sewer mains.
- Please watch for adjusted pedestrian routes.
Interior Work
Tower A
- Steel stud framing of interior partitions and soffits continues.
- Drywall installation and taping is ongoing.
- Installation of hollow metal door frames continues.
- New window installation continues.
- Plaster patching at columns and beams continues.
- Modernization of the Tower elevators by Otis Elevator Company continues.
- Rough-in of HVAC piping, electrical, fire alarm, plumbing, and sheet metal ductwork continues.

- Pressure testing of mechanical piping and sheet metal ductwork continues.
- Application of spray fireproofing, expanding foam insulation, and firestopping continues.
- Third-party inspectors are onsite weekly as needed.
Tower B
- Survey work in Tower B common corridors will require minor selective demolition within tented enclosures.
Dining Hall
- Exploratory and enabling work, field measuring, and mockups will be ongoing while the dining hall is closed.
Parking Garage
- Loading Dock Closure – Concrete Slab Repairs: The loading dock will be closed from Monday, December 22, 2025, through Monday, January 19, 2026. Deliveries should use the westerly side of the South Alley on Cummington Mall West.
- Fiber optic cabling relocation will impact the network beginning January 6, 2026.
- Work continues in the main electrical room.
- Electricians continue running wiring and conduits throughout the garage.
- Installation of the Tower A electrical bus duct riser continues.
- Plumbers continue installing new water and drain lines.
- Construction of a new Parking & Transportation office continues.


- Installation of new suspended electrical duct bank and grounding loop system continues.
- Construction of the new fuel storage room continues.
- Concrete and steel structural repairs continue.
- Sprinkler work continues on all levels.
- Masons continue installing block walls in the new mechanical and electrical rooms.
- Temporary heaters will be operating on Level 3.
- Please watch for adjusted parking patterns, BUPD detail officers, cones, and observe signage.
Future / Notable Tasks
- Third-section window leak testing on Tower A.
- FM Global roof uplift testing will begin.
- Crane lift of the emergency generator onto the Tower A roof.
